Executive Summary
Effective facilities management in Abu Dhabi is a strategic imperative, not an operational expense. For asset owners, property managers, and procurement leaders, the primary objective is to transition from a reactive, cost-centric model to a proactive, risk-based framework. This guide provides a technical foundation for evaluating FM contracts, defining meaningful Service Level Agreements (SLAs), and ensuring compliance with Abu Dhabi's stringent regulatory landscape. The focus is on protecting asset value, ensuring operational continuity, and achieving predictable operating expenditure (OPEX) through structured, engineering-led maintenance planning.
Table of Contents
- Executive Summary
- The Role of Strategic Facilities Management in Abu Dhabi
- Defining the Scope of Hard and Soft FM Services
- Navigating Abu Dhabi's Regulatory and Compliance Framework
- A Decision Framework for FM Contract and SLA Structures
- Benchmarking Costs and Evaluating Vendor Proposals
- Integrating Technology and Sustainability in Modern FM
- Frequently Asked Questions (FAQ)
The Role of Strategic Facilities Management in Abu Dhabi
Strategic facilities management moves beyond the reactive "fix-it-when-it-breaks" approach. It positions FM as a core business function that actively manages asset value and mitigates operational risk. For entities operating in Abu Dhabi's demanding environment, this translates to a sharp focus on minimizing downtime, controlling operating expenditure (OPEX), and maintaining full compliance with local authorities like the Abu Dhabi Municipality and Civil Defence.
The primary goal is to shift how FM is perceived—from a mandatory cost center to a source of measurable, predictable value. This is achieved through preventive planning that extends the lifecycle of critical assets, optimizes energy consumption, and maintains operational integrity.
A robust FM strategy is built on three operational pillars:
- Asset Performance & Lifecycle Management: This involves ensuring the building’s systems, particularly HVAC units under constant high thermal load, operate at specified efficiency levels. The objective is to prevent premature failure and defer capital replacement costs through rigorous preventive planning.
- Regulatory & Compliance Adherence: Meeting all mandates from bodies like the Abu Dhabi Civil Defence (ADCD) and adhering to the Estidama Pearl Rating System for sustainability is non-negotiable. Compliance is a direct measure of operational discipline.
- Financial Control & OPEX Predictability: This is achieved by structuring contracts, such as a comprehensive Annual Maintenance Contract (AMC), to fix OPEX and eliminate the financial volatility associated with emergency rectification works.
This methodology requires a deep, engineering-led understanding of Abu Dhabi’s specific operational challenges. For a broader regional perspective, our analysis of facilities management in the UAE provides wider context.
Defining the Scope of Hard and Soft FM Services
In facilities management, service delivery is bifurcated into two core streams: Hard FM and Soft FM. A clear definition of scope is the first step in constructing a maintenance contract that effectively mitigates risk and aligns with budgetary goals.
Hard FM encompasses the technical, engineering-led services required to maintain a building’s core infrastructure—its mechanical, electrical, and plumbing (MEP) systems. Soft FM, conversely, includes the labor-intensive services focused on the user experience, such as cleaning, security, and waste management.
Given Abu Dhabi’s climate and the complexity of its built environment, Hard FM services are critical for operational continuity and asset integrity. They are physically integrated into the building and are essential for safety, compliance, and functionality.
Market data confirms this focus. The UAE's facility management market is projected to reach USD 33.64 billion by 2030, with hard services consistently accounting for over 60% of total contract value. For assets on the scale of the 30 million square meters of government-managed space in Abu Dhabi, the technical maintenance burden is immense. Further market analysis can be found in this industry report.
Core Components of Hard FM
Hard FM is centered on asset lifecycle management, preventive planning, and regulatory compliance. Execution requires certified technicians, and services are typically governed by structured Annual Maintenance Contracts (AMC) to preempt failures.
Key services include:
- Mechanical Systems: Primarily HVAC (Heating, Ventilation, and Air Conditioning). In Abu Dhabi’s climate, HVAC is a life-support system. Maintenance is focused on managing extreme heat stress and humidity to prevent system failure, which can render a building uninhabitable.
- Electrical Systems: This covers power distribution, lighting, backup generators, and Uninterruptible Power Supply (UPS) systems. The objective is to ensure 100% power availability and quality for critical business operations.
- Plumbing & Water Systems: Involves the maintenance of water pumps, tanks, drainage, and sanitation infrastructure to meet Abu Dhabi’s stringent public health and safety regulations.
The Role of Soft FM
If Hard FM is the building’s engineering core, Soft FM addresses the human interface. These are people-centric services that directly influence occupant satisfaction and the property's operational standard.
Operational Integration: In practice, Hard and Soft FM are intrinsically linked. A burst pipe (a Hard FM failure) immediately triggers a Soft FM requirement: water cleanup, area cordoning, and safety management. An integrated FM model, where a single provider manages both scopes, is critical for seamless incident response and clear accountability.
Key Soft FM services include:
- Cleaning and Janitorial Services: Routine and deep cleaning, façade maintenance.
- Security Services: Access control management, CCTV monitoring, and on-site personnel.
- Landscaping and Grounds Maintenance: Upkeep of all external areas.
The most operationally resilient facilities integrate both Hard and Soft FM under a unified management structure to ensure clear communication and accountability.
Navigating Abu Dhabi's Regulatory and Compliance Framework
In Abu Dhabi, compliance is a core operational function, not an administrative task. The capital's regulatory environment is prescriptive, with government bodies dictating standards for safety, public health, and sustainability. An FM provider's fluency in this landscape is a primary defense against operational risk.
Three key authorities define the compliance reality for any building:
- Abu Dhabi Municipality: Governs building codes, structural works, and public health standards, including waste disposal and pest control protocols.
- Abu Dhabi Civil Defence (ADCD): Holds ultimate authority on fire and life safety. ADCD enforces strict inspection, testing, and maintenance (ITM) schedules for all fire alarms, sprinklers, and emergency systems, with zero tolerance for deviation.
- Department of Energy (DoE): Sets efficiency targets and monitors energy and water consumption, driving conservation efforts across the emirate.
The Central Role of Estidama
While the above bodies set specific rules, the Estidama Pearl Rating System is the single most influential factor shaping building operations. Originally a design framework for new construction, it now functions as a continuous operational standard. A building’s Pearl Rating is not a one-time achievement but a performance benchmark that must be actively maintained through daily FM practices.
Risk Perspective: From a risk management standpoint, non-compliance represents a direct threat to business continuity. Fines for fire safety violations can be substantial, but the greater risk is an operational shutdown order, which can halt business activities and cause severe financial and reputational damage.
Translating Regulations into Daily FM Tasks
A competent FM provider integrates compliance directly into their preventive maintenance plan. The PPM schedule should show a clear lineage to the specific regulations it is designed to satisfy.
This looks like:
- ADCD Compliance: Quarterly, semi-annual, and annual tests of all fire pumps, alarms, and suppression systems, with meticulous logging for ADCD inspections. Failure to produce a compliant logbook is a breach.
- Estidama Mandates: Proactive energy management, including tracking water use with sub-meters to detect leaks and fine-tuning HVAC systems to meet DoE efficiency targets.
- Municipality Adherence: Scheduled water tank cleaning, documented waste segregation, and ensuring all repair work is performed by certified technicians.
Successfully navigating this environment demands an integrated strategy where compliance is embedded in every maintenance task. Many asset owners find the clearest path to compliance is by partnering with specialised MEP companies in Abu Dhabi that possess deep, engineering-led knowledge of local codes.
A Decision Framework for FM Contract and SLA Structures
Selecting the appropriate facilities management contract in Abu Dhabi is a strategic risk-management decision that directly impacts budget predictability and asset longevity. The agreement's structure determines everything from financial liability for equipment failure to contractually-guaranteed response times.
An effective contract aligns the commercial model (payment structure) with the Service Level Agreement (SLA), which defines performance standards. Misalignment between these two components exposes an asset to significant operational and financial risk.
Scenario Comparison: FM Contract Models
The UAE market predominantly features three contract models, each presenting a different trade-off between upfront cost and long-term risk exposure. The optimal choice depends on asset complexity and an organization's tolerance for unbudgeted expenditure.
This table provides a comparative analysis of common contract models for decision-makers in Abu Dhabi.
| Attribute | Comprehensive AMC | Non-Comprehensive (Labour-Only) AMC | Reactive (Call-Out) Model |
|---|---|---|---|
| Cost Structure | Fixed annual fee covering all labour, consumables, and spare parts. | Fixed fee for preventive maintenance labour. Spare parts and corrective labour are billed as a variable cost. | Per-job payment. No fixed costs, but high hourly rates and material markups apply. |
| OPEX Predictability | High. Provides a fixed annual maintenance budget, enabling reliable financial planning. | Low to Medium. Base cost is known, but total OPEX is volatile and dependent on failure rates. | Very Low. Costs are entirely unpredictable and can escalate significantly during major system failures. |
| Risk to Asset Owner | Low. The FM provider assumes the financial risk for most equipment failures, incentivizing preventive maintenance. | Medium. The owner retains full financial risk for all component failures, creating a significant liability for critical assets. | High. The owner bears all risk: downtime, repair costs, and emergency call-out premiums. |
| Asset Lifecycle Impact | Maximized. The provider is financially motivated to perform high-quality preventive maintenance to control their own costs. | Variable. Quality of preventive work may be inconsistent as there is no financial incentive to prevent failures. | Reduced. This "run-to-fail" approach accelerates asset degradation and shortens the operational lifespan. |
The reactive model, while cheapest upfront, carries the most risk and demonstrably shortens asset life. A comprehensive model functions as a powerful risk mitigation tool.
Defining SLAs and KPIs for Operational Control
The Service Level Agreement (SLA) is the core of the FM contract, translating operational expectations into measurable, enforceable targets. Vague SLAs are a primary source of performance disputes.
An effective SLA must specify:
- Response Times: The time elapsed from fault logging to technician arrival on-site, tiered by priority. For a critical failure (e.g., HVAC failure in a data center), a response time of <30 minutes is standard. For a non-critical issue, 4-8 hours may be acceptable.
- Rectification Times: The maximum time allowed to resolve the issue. This is often more critical than response time and must also be tiered by priority.
- Key Performance Indicators (KPIs): The quantitative metrics used to measure provider performance. Focus on what directly impacts operations, such as Preventive Maintenance Plan (PMP) Completion Rate (target: 98-100%), First-Time Fix Rate (target: >85%), and Asset Uptime for critical systems (chillers, generators, elevators).
A contract that bundles technical support with parts and labour, such as a well-structured Annual Maintenance Contract (AMC), delivers the highest level of operational security by aligning the provider's financial interests with the asset's health.
Benchmarking Costs and Evaluating Vendor Proposals
Evaluating proposals for facilities management in Abu Dhabi requires analysis beyond the bottom-line price. A low-cost bid often indicates high operational risk, whereas a value-driven proposal is centered on lifecycle asset management and supported by transparent performance metrics.
Cost variations are typically driven by technical depth (in-house vs. subcontracted labor) and the technology stack (use of CAFM/CMMS systems). A provider with a large, certified in-house technical team will have higher overheads than a firm that subcontracts work, but the former offers superior quality control and response capability. Similarly, a vendor utilizing a modern Computer-Aided Facility Management (CAFM) system provides data transparency, which is a value-add reflected in the cost.
Assessing a Vendor's Operational Maturity
To differentiate between a low-cost, high-risk bid and a value-engineered proposal, shift the evaluation from price to operational capability using these criteria:
- Request ISO Certifications: Verify ISO 9001 (Quality Management), ISO 45001 (Health & Safety), and ISO 14001 (Environmental Management). These certifications are evidence of structured, auditable processes.
- Review Sample Schedules: Request a sample Preventive Maintenance (PM) schedule for a similar asset. It should be detailed, referencing specific tasks and frequencies aligned with manufacturer recommendations and local codes. A generic checklist is a red flag.
- Examine Reporting Formats: Request a sample monthly performance report. It should contain data-driven KPIs (asset uptime, first-time fix rates, SLA adherence), not just a list of completed tasks.

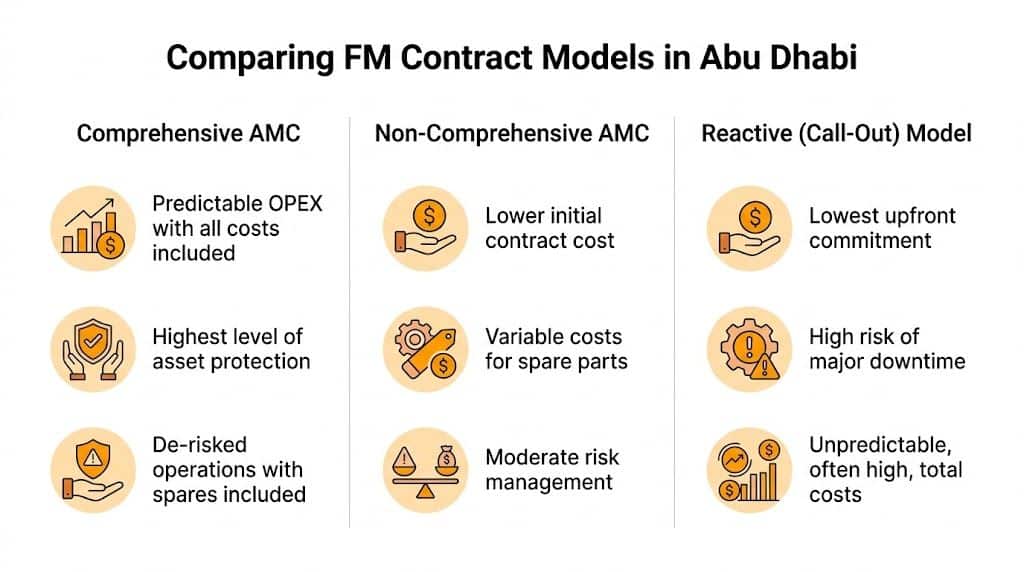

The infographic below illustrates the financial and risk implications of different contract models.
As shown, comprehensive models require a higher initial investment but significantly de-risk operations by providing predictable OPEX.
Indicative Cost Benchmarks
While asset class, age, and complexity are primary cost drivers, some benchmarks can guide initial budgeting. For standard hard FM services in Abu Dhabi, costs typically range from AED 8 to AED 18 per square foot per year for commercial properties. Premium assets with complex systems and stringent SLAs may exceed this range.
A proposal significantly below this benchmark warrants scrutiny. It may indicate a non-comprehensive scope, exclusion of critical assets, or reliance on low-skill subcontracted labor—all factors that increase the total cost of ownership.
Effective facilities management also involves identifying cost-saving opportunities in all operational domains. For example, understanding how to reduce commercial waste disposal costs contributes to a holistic efficiency strategy.
A strong proposal demonstrates how its service model, often delivered via structured HVAC maintenance contracts, will protect asset value and control lifecycle costs, rather than merely offering the lowest price.
Integrating Technology and Sustainability in Modern FM
In Abu Dhabi's facilities management sector, sustainability mandates and technology integration are no longer optional. The government's push for sustainability via the Estidama Pearl Rating System and the operational efficiencies gained from technology require FM providers to function as strategic partners in energy management and data-driven performance.
This creates demand for sophisticated services like energy audits and retro-commissioning, which aim to reduce consumption by optimizing major systems, particularly HVAC and water infrastructure—a critical function in the UAE's climate.
This operational evolution is occurring within a growing market, fueled by major real estate developments. With Abu Dhabi and Dubai accounting for an estimated two-thirds of the UAE’s total FM contract value, the capital’s role is expanding. A closer examination of these regional market dynamics is available in TechSci Research's market report.
How Technology Directly Impacts FM Performance
Technology enables the achievement of sustainability targets by connecting high-level energy goals with practical, on-the-ground maintenance activities.
The core value of technology in FM is the transition from reactive rectification to predictive, data-driven interventions. This shift has a direct, quantifiable impact on OPEX, asset longevity, and technician productivity.
Key technologies transforming building management include:
- Computer-Aided Facility Management (CAFM): These systems act as a digital command center, providing a single source of truth for work order management, preventive maintenance scheduling, and asset service history. This creates an auditable record essential for compliance verification.
- IoT Sensors: The Internet of Things (IoT) enables predictive maintenance. Sensors monitoring real-time data on equipment like chillers and pumps (vibration, temperature, energy consumption) can identify indicators of potential failure long before it occurs, allowing for planned, non-disruptive rectification.
To manage these complex systems, many organizations implement specialized platforms. For instance, dedicated HVAC business management software can optimize maintenance scheduling and resource allocation. In practice, these systems are typically managed under structured MEP services in Dubai contracts, where technology provides transparent, data-driven insights for smarter OPEX and CAPEX planning.
Frequently Asked Questions (FAQ)
Q: What is the primary difference between facilities management in Abu Dhabi versus Dubai?
A: The key operational distinction is Abu Dhabi's rigorous enforcement of sustainability through its Estidama Pearl Rating System, which dictates continuous performance monitoring. Dubai's market is comparatively more driven by the private commercial sector. Abu Dhabi’s FM landscape is also heavily influenced by large-scale government projects with unique compliance mandates.
Q: How do I formulate a realistic budget for FM services in Abu Dhabi?
A: A realistic budget is a function of asset age, technical complexity, and required service levels. While per-square-foot benchmarks are a starting point, a robust budget must also account for potential uncapped costs, such as spare parts and emergency labour, if not covered by a comprehensive contract. A significant, non-negotiable line item for a property in this climate is a comprehensive HVAC maintenance contract.
Q: What are the most critical KPIs for a commercial tower's FM contract?
A: For a commercial tower, KPIs must be tied to tenant retention and asset protection. Critical metrics include:
- HVAC System Uptime & Temperature Compliance: Maintaining ambient temperature within the agreed range (e.g., 22°C ±2°C).
- Critical System Response Time: A contractually obligated response of <30 minutes for critical failures (e.g., power outage, major leak).
- First-Time Fix Rate: A measure of technical competency, with a target of >85%.
- Preventive Maintenance Completion Rate: A leading indicator of asset health, which should be 100% on schedule.
Q: What is the difference between a comprehensive and non-comprehensive AMC?
A: A comprehensive Annual Maintenance Contract (AMC) includes all labour, spare parts, and consumables for a fixed annual fee, transferring the financial risk of failure to the service provider. A non-comprehensive (or labour-only) contract covers only preventive maintenance labour, leaving the asset owner liable for the variable and often high costs of spare parts and corrective work.
Q: How do SLAs impact operational risk?
A: Service Level Agreements (SLAs) directly mitigate operational risk by defining contractually enforceable standards for performance. A well-defined SLA with tiered response/rectification times and clear KPIs ensures that the provider's performance is aligned with the asset's business continuity needs. Vague or missing SLAs create ambiguity and expose the asset to extended downtime and potential secondary damages. These are the core of effective Annual Maintenance Contracts (AMC).
Meta Description: A 2026 technical guide for facilities management in Abu Dhabi. Learn to evaluate contracts, define SLAs, manage OPEX, and ensure compliance in the UAE capital.
