A lift trips repeatedly in a residential tower. Guest room temperatures drift in a hotel wing. An electrical panel shows signs of overheating, but the log sheet says the last inspection was completed. In such instances, most Dubai asset teams frequently lose time and money. The problem usually isn’t a lack of maintenance activity. It’s a lack of structured, verifiable preventive control.
A proper preventive maintenance checklist gives building operators something paper-heavy maintenance systems often fail to provide: a repeatable standard for execution, evidence for compliance, and a usable record for asset decisions. In UAE conditions, that matters more than many owners initially assume. Heat, dust, humidity cycles, and local compliance requirements punish vague maintenance routines very quickly.
Table of Contents
- From Reactive Failures to Proactive Control
- Anatomy of a Professional Preventive Maintenance Checklist
- System-Specific Checklists for Commercial & Mixed-Use Buildings
- Adapting Checklists for UAE Climate and Compliance
- Integrating Checklists into Digital Workflows and AMCs
- Frequently Asked Questions
From Reactive Failures to Proactive Control
When an asset manager relies on reactive maintenance, the maintenance team spends its day chasing symptoms. Technicians move from complaint to complaint. Procurement gets rushed into emergency buying. Site managers lose confidence in the service records because the same assets keep failing. That operating model is common, but it isn’t stable.
Why reactive maintenance distorts cost control
Structured PM changes the economics. Organisations adopting structured preventive maintenance programmes report 52.7% less unplanned downtime than those relying on reactive maintenance, and downtime for major MEP systems in Dubai can cost upwards of $125,000 per hour. The same benchmark notes that each dollar invested in preventive maintenance typically saves an average of $5 in future repairs according to maintenance statistics on planned versus reactive work.
That matters in offices, malls, hotels, and mixed-use towers because the direct repair cost is only one part of the problem. The larger risk sits in business interruption, SLA breaches, tenant dissatisfaction, temporary shutdowns, and accelerated asset degradation. A chiller that runs inefficiently for months before failure doesn’t just break once. It consumes budget long before the breakdown is visible.
Practical rule: If a task can't be checked, evidenced, and trended, it usually isn't being controlled.
A preventive maintenance checklist is often misunderstood as an administrative form. In practice, it’s a control document. It defines what must be inspected, what acceptable condition looks like, who signed off, what readings were taken, and whether rectification is needed.
What a checklist actually controls
The strongest checklists reduce ambiguity in four areas:
- Task execution: Technicians follow the same sequence every cycle, instead of relying on memory.
- Risk visibility: Supervisors can identify failed steps, deferred items, and recurring defects.
- Commercial accountability: Service providers can be measured against scope, frequency, and SLA.
- Asset value protection: Owners get a maintenance history that supports lifecycle planning and warranty discussions.
For Dubai portfolios, this is the practical shift. You move from “was maintenance done?” to “was the correct maintenance completed, on time, to standard, with evidence?” That’s the threshold that separates a functioning PM regime from a collection of service visits.
Asset teams reviewing service models often find it useful to compare preventive vs reactive maintenance cost analysis for different property types because the decision isn’t only technical. It’s financial, operational, and contractual.
Anatomy of a Professional Preventive Maintenance Checklist
A professional checklist isn’t a list of generic tasks like “check AHU” or “inspect panel”. That kind of template creates false confidence. Technicians tick boxes, but the owner still has no reliable record of actual condition, compliance status, or pending risk.
The fields that belong on every serious checklist
At minimum, a usable preventive maintenance checklist for UAE facilities should include:
- Asset identification: Asset ID, asset type, make, model, and exact location. “Pump room” is too vague in a large property.
- Maintenance frequency: Daily, weekly, monthly, quarterly, bi-annual, or annual coding tied to the PM planner.
- Task sequence: Step-by-step instructions in the right order, especially where shutdown and restart procedures matter.
- Safety controls: PPE requirement, isolation point, and Lockout/Tagout reference where applicable.
- Pass or fail criteria: Observable standards, readings, tolerance bands, or defect descriptions.
- Compliance reference: Space to note relevant Dubai Municipality, Civil Defence, building code, or internal SOP requirement.
- Technician evidence: Name, time stamp, signature, and where possible, photos or meter readings.
- Follow-up action: Defect category, urgency, rectification note, and whether a corrective work order was raised.
These fields turn a checklist into an operating record. Without them, the document has little value in an audit, dispute, warranty review, or root-cause analysis.
A checklist should tell a supervisor what was done, tell an auditor what was verified, and tell an asset manager what needs funding next.
Basic versus audit-ready checklist design
The difference is usually obvious in one site visit.
| Field | Basic Checklist | Comprehensive (Audit-Ready) Checklist |
|---|---|---|
| Asset reference | Asset name only | Asset ID, location, make, model |
| Task detail | Generic task title | Sequential steps with clear criteria |
| Safety | “Use PPE” | Specific isolation and LOTO requirements |
| Measurements | Rarely included | Readings, tolerances, observations |
| Compliance | Not referenced | Regulation or SOP reference included |
| Evidence | Tick mark only | Time stamp, technician name, photo, comments |
| Defect handling | Separate verbal note | Built-in rectification and escalation field |
| Reporting use | Limited | Suitable for SLA, audit, and trend review |
A useful way to think about this is to compare it with other asset-heavy industries. Even outside building services, technical teams use structured schedules because maintenance quality collapses when task sequencing and proof of completion are weak. For a practical example of how maintenance templates are structured in another operational environment, the drone preventive maintenance schedule template is worth reviewing. The asset type is different, but the discipline is the same: identify the equipment, define the steps, capture evidence, and make the record usable later.
Checklist design also needs one commercial discipline that many owners skip. Every recurring PM task should link back to scope. If a contractor’s AMC includes quarterly inspection but not deep cleaning, thermography, balancing, or calibration, the checklist must reflect that. Otherwise the site team assumes tasks are covered when they aren’t, and the dispute only appears after failure.

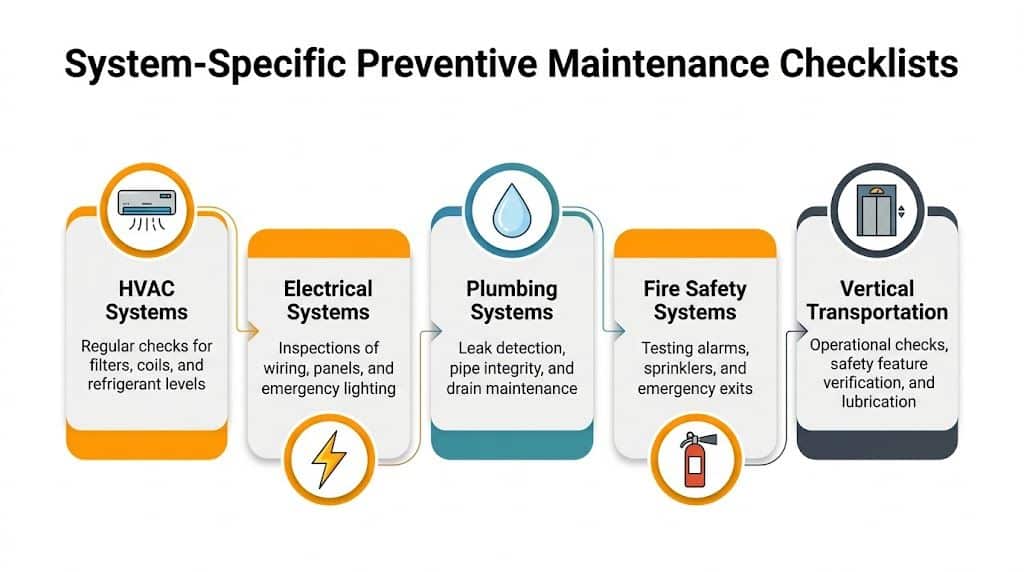

System-Specific Checklists for Commercial & Mixed-Use Buildings
Generic templates fail fastest on technical systems. HVAC, electrical, plumbing, and fire life safety assets don’t fail in the same way, and they shouldn’t be maintained from the same checklist structure.
HVAC systems
In UAE buildings, HVAC usually carries the highest operational exposure because climate stress is constant and tenant comfort expectations are unforgiving. A proper HVAC preventive maintenance checklist starts with safety isolation and proceeds in sequence. Best-practice guidance for UAE conditions includes Lockout/Tagout, coil cleaning to ASHRAE standards for desert climates, and temperature sensor calibration to ±1°C accuracy. The same guidance notes that achieving over 95% PM compliance can reduce reactive maintenance calls by 40% and improve MTBF from 6 to 18 months according to this HVAC preventive maintenance guide.
For HVAC assets, the checklist should usually include:
- Air-side tasks: Filter condition, coil cleanliness, fan belt wear, bearing noise, condensate tray condition, drain clearance.
- Control checks: Sensor calibration, thermostat response, actuator function, BMS communication status.
- Mechanical review: Vibration, lubrication, mounting condition, refrigerant-related observations where relevant.
- Operational testing: Start-up verification and staged load checks after maintenance activity.
Many FM teams also use a more detailed industrial preventive maintenance checklist as a reference point for critical plant assets because the discipline required for packaged units, pumps, and plantroom equipment is similar.
Electrical systems
Electrical PM templates should focus less on generic “inspection” and more on verifiable condition. That means the checklist needs fields for terminations, insulation condition, thermal anomalies, panel cleanliness, earth continuity observations, emergency lighting status, and signs of moisture ingress or overheating.
The sequence matters. Isolate if required. Verify safe access. Inspect enclosure integrity. Check for dust accumulation and discolouration. Confirm label legibility. Record any abnormal smell, heat marking, or looseness. If the task includes testing, the form should identify the reading to be entered and who is authorised to perform it.
A weak electrical checklist often creates the worst kind of risk. It shows completion without proving anything meaningful.
Plumbing systems
Plumbing PM in mixed-use buildings is rarely glamorous, but neglect here becomes expensive fast. Water leakage, pressure irregularities, blocked drainage, failed transfer pumps, and concealed corrosion all create secondary damage that extends beyond the original fault.
A useful plumbing checklist should cover three layers:
- Visual integrity checks for pipework, valves, supports, insulation, and evidence of leakage.
- Functional checks for transfer pumps, booster sets, float controls, drainage flow, and pressure behaviour.
- Hygiene and housekeeping controls around tanks, pump rooms, and drainage points.
In hotels and residential towers, the checklist should also distinguish between common-area systems and in-unit or in-room assets. The response path and access requirements are not the same.
If your plumbing checklist only records “no leak found”, it isn't a maintenance record. It’s a placeholder.
Fire and life safety systems
Fire and life safety checklists should never be folded casually into a general handyman format. The tasks, records, and sign-off chain must reflect the seriousness of the system.
The practical checklist normally includes:
- Alarm and detection review: Panel status, fault indication, interface condition, detector accessibility.
- Suppression readiness: Sprinkler head condition, valve position, fire pump indicators, pressure observations.
- Egress and support items: Exit route obstruction check, emergency light status, signage visibility, fire door condition.
- Documentation control: Defect status, impairment note, escalation route, and coordination with competent specialists where required.
For asset owners, the key issue isn’t only whether a monthly inspection occurred. It’s whether the record would stand up if an authority, insurer, or forensic reviewer asked for evidence after an incident. That is why system-specific PM templates should be treated as engineering documents, not cleaning schedules with extra boxes.
Adapting Checklists for UAE Climate and Compliance
Imported templates often look tidy on paper and fail in operation. The reason is simple. UAE buildings don’t operate under generic conditions. Heat loading, airborne dust, humidity swings, coastal corrosion exposure, and local authority requirements all change what a checklist needs to ask and how often tasks need to occur.
Climate loading changes maintenance intervals
Dust is the most underestimated variable in many Dubai PM regimes. Filters clog faster, coils foul earlier, moving parts wear more quickly, and heat rejection performance degrades before occupants notice the comfort problem. A 2025 UAE FM Association study reported that preventive checklists reduced HVAC breakdowns by 55% in Dubai malls when they included bi-annual infrared thermography under ASHRAE 180 UAE-adapted standards. The same study noted that standard templates often overlook that desert dust can accelerate wear by 30% according to this preventive maintenance checklist reference.
That finding matches what experienced site teams already see. A generic annual deep-cleaning interval copied from a temperate market can be too slow for a high-load UAE building. The checklist must reflect local operating stress, not just OEM paperwork.
This usually means adapting templates for:
- Heat stress: Check for insulation breakdown, nuisance tripping, drift in controls, and reduced component life under sustained temperature.
- Dust loading: Increase inspection emphasis on filters, coils, panels, louvers, bearings, and exposed moving assemblies.
- Humidity and salinity: Watch for corrosion, condensation, terminal oxidation, and enclosure seal failure, especially near the coast.
Compliance evidence must be built into the template
A second gap appears in compliance. Many contractors carry out the technical task but fail to build compliance evidence into the checklist itself. That creates trouble during audits and dispute resolution because the work may have been done, yet the record can’t prove scope, timing, or verification.
For Dubai assets, the checklist should include room for the following:
- Authority reference: The relevant internal SOP, permit requirement, or compliance trigger tied to Dubai Municipality or Civil Defence obligations.
- Verification point: What exactly confirms completion. A reading, a photo, a panel status, a valve position, or a supervisory sign-off.
- Defect pathway: Immediate rectification, temporary control, shutdown recommendation, or specialist escalation.
- Retention standard: Where the record is stored and how it can be retrieved during inspection or contract review.
Maintenance and asset protection converge. A checklist that accounts for climate but ignores compliance is incomplete. A checklist that references compliance but ignores climate is equally risky. In UAE building operations, both have to sit in the same working document.
For owners procuring MEP services in Dubai, this point is practical rather than theoretical. You’re not just buying labour. You’re buying a maintenance system that needs to perform in local environmental conditions and produce evidence that the work was completed to an acceptable standard.
Integrating Checklists into Digital Workflows and AMCs
Paper checklists still exist in many portfolios because they feel familiar and inexpensive. In practice, they create blind spots. Sheets go missing. Handwriting is unclear. Time stamps are weak. Photos sit in personal phones. Supervisors sign bundles of forms at the end of the week without seeing the asset condition.
Why paper checklists fail under scrutiny
The issue isn’t convenience. It’s verification. In the UAE, a 2025 DEWA report indicated that 68% of electrical downtime in Dubai's Grade A offices stems from unverified maintenance logs. It also reported that only 22% of FMCs currently use photo-capturing apps, and that photo-based checklists with SLA-driven sign-offs can reduce audit failures by 40% according to this guide to creating preventive maintenance checklists.
That gives asset managers a clear decision point. If the maintenance record cannot prove condition, task completion, and timing, the checklist isn’t serving its operational purpose.
Digital workflow fixes several persistent problems:
- Proof of execution: Photos, readings, and technician sign-off sit inside the work order.
- SLA tracking: Time stamps show whether tasks were completed within contract windows.
- Defect closure: Failed PM items can trigger corrective work orders instead of disappearing into email.
- Reporting quality: Managers can review completion status by site, asset class, or contractor.
Teams that are redesigning their forms often benefit from reviewing broader guidance on form integrations for seamless data flow, especially when PM records need to connect with helpdesk, asset, procurement, or reporting tools.
How digital checklists support AMC delivery
Annual maintenance contracts work best when the checklist is part of the delivery mechanism rather than an afterthought. In a structured AMC, the PM template defines recurring scope, the work order system issues the task, the technician completes the checklist in the field, and management reviews exceptions rather than chasing paperwork.
That’s also where photo-based tools become useful. Platforms such as technology-enabled maintenance with IoT monitoring and predictive maintenance solutions can sit alongside routine PM to improve verification and trend visibility. SnapFixNow, for example, uses a photo-based work order approach for maintenance reporting in Dubai. The relevant point isn’t the brand. It’s the operating method: checklist, evidence, sign-off, and retrievable record.
Digital PM isn't just a software change. It changes who can verify work, how quickly defects are escalated, and whether the owner can enforce the contract.
For procurement and asset teams, that’s the practical implementation pathway. Build system-specific checklists. Attach them to recurring work orders. Require photo verification on critical tasks. Review exceptions monthly. Tie all of it back to AMC scope, response obligations, and lifecycle priorities.
Frequently Asked Questions
Q: What should a preventive maintenance checklist include for a Dubai commercial building?
A: It should include asset identification, location, task sequence, safety steps, pass or fail criteria, technician sign-off, defect notes, and compliance references where relevant. For critical systems, it should also capture readings, photos, and rectification follow-up.
Q: How often should preventive maintenance checklists be reviewed and updated?
A: Review them whenever failure patterns change, seasonal load shifts become visible, new authority requirements apply, or the building adds new equipment. In UAE conditions, the schedule and task detail often need adjustment because dust, heat, and humidity affect assets differently across sites.
Q: Are paper checklists still acceptable?
A: They can be used, but they create avoidable control gaps. Paper records are harder to verify, audit, trend, and retrieve. For assets with compliance exposure or high downtime cost, digital and photo-based records are usually the more reliable option.
Q: Should one checklist be used across all building systems?
A: No. HVAC, electrical, plumbing, and fire life safety systems need different task logic, failure indicators, and sign-off requirements. A common format for headers and reporting is useful, but the technical content should remain system-specific.
Q: How does a checklist affect an AMC decision?
A: It helps you evaluate whether the contract is operationally credible. If the provider can’t show the actual PM template, evidence method, and defect escalation path, the AMC may be labour supply dressed up as maintenance management.
In practice, these controls are usually implemented through structured maintenance contracts supported by clear SOPs, digital work orders, and recurring engineering review. If you’re assessing how to standardise preventive maintenance across a Dubai portfolio, SnapFixNow is one example of a local FM operator using photo-based work order reporting, AMC delivery, and engineering-led hard FM processes in that model.
